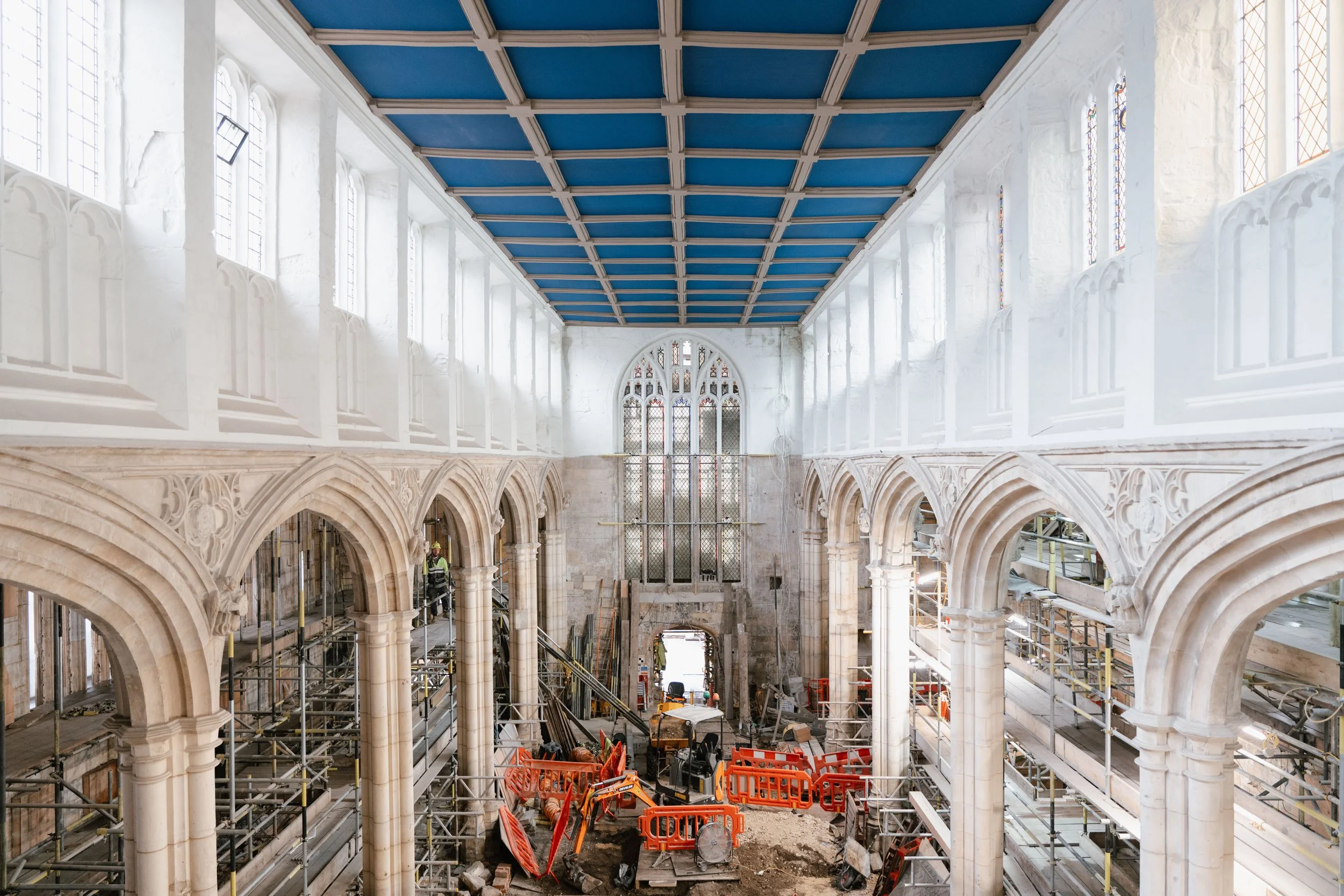

The view of the interior, looking towards the west end, in May 2026.
What’s happened in the last year?
A year ago we were in a £1.5 million hole due to the end of the Listed Places of Worship grant scheme. In an amazing answer to prayer, the day before we were due to instruct our architects to remove large parts of the project that we could no longer afford, an anonymous donor stepped forward to cover this entire funding gap! We continued to lobby the government for our sake and on behalf of other churches in similar positions.
Construction ramped up this year! The most significant elements were:
Roof repairs: the nave has been entirely restored and re-leaded; south and north aisle roof repairs and releading are in progress. The leadwork is of incredible quality; removal of old lead meant we have been able to record and retain a number of pieces of panels including historic graffiti. Woodwork repairs were underestimated - 20% increased to 80%: this caused significant delays, and an increased cost of £76,000.
Stone repairs: these are about 50% complete, and will continue into 2027. There was a significant increase in the amount of work required, and we had to switch quarries, which all caused more delays and cost £686,000 - half of this cost has come to us. The magnesian limestone and location of the church has meant that this area of the building’s fabric has needed repair for a long time.
Stained glass: Barley Studios continues to repair and conserve our stained glass. The windows have been reinstalled in the clerestory which look stunning! Environmental Protective Glazing has been installed at the East End to protect our 14thC stained glass window above the altar. The design has been finalised for the new West window.
Internal repairs & redecoration: Clerestory stonework and ceiling panel repairs are complete! Protective limewash over the stone walls is complete and ceiling panels have been painted in ‘deep space blue’. Some internal scaffolding has therefore been able to be removed.
Bell: Our bell has been rehung! The stonework and roof of the belltower have been repaired, a lighting scheme has been designed, and the bell will be able to be rung again - electronically!
Ground level archaeology: Floor ledger stones have been lifted and removed for repair and reinstallation of the majority; continued opening of the nave floor in recent months has revealed burial vaults with lead coffins and further ledger stones. Coffins will be reburied (with appropriate services of reinterment by our clergy). The archaeological watching brief, which includes detailed recording and reporting, together with records the project team is creating, will inform our visitor information and future academic study.
Some of the increased costs shared above have been picked up by the Chancel Repair Liability which is held by the Church Commissioners on the Minster’s behalf.
The quality of the work across the roof repairs, stonework and leadwork is exceptional, receiving acclaim from visitors and advisors in the conservation sector.
Other things we’ve been working on:
Visitor interpretation: Work with the Centre for the Study of Christianity & Culture at the University of York continued, documenting the building before, during (and after) the project, as well as capturing discovered items and pulling it all together to create a narrative which we will be able to share with visitors both in person and online in the UK and globally.
Moving back into the building: Strategic development of the Operations plan for the handover and life back in the church building has begun this year.
Project Management Team: From January 2025, four of us have worked together. Initially on a trial basis, this has proved beneficial as it maintains a Project Management presence across the week, using a wide variety of skills to progress different elements of the project and tie in more closely with central church operations, strategy and vision.
What’s coming next?
The expected end date of the project is now early Summer 2027. This is a delay of about a year, which is primarily due to the substantial roof woodwork and stone repairs required.
To help meet the costs of this delay, we have recently launched a fundraising campaign with a target of £500,000 in 2026. The majority of this funding will be sought from grant making bodies, and we are inviting the church members to contribute £100,000 through pledging regular giving for the next 1-3 years in a way that suits them, or by making one-off gifts.
Find out more about pledging and giving to Impact.
Get involved!
PRAY
We are currently in 21 Days of Prayer & Fasting - join us in interceding for BREAKTHROUGH for Impact.
Get involved with fasting and praying during this time - there are some brilliant prayer stations at The Well at St Cuthbert’s. We’re praying and fasting for:
Breakthrough in project timing
Breakthrough in fundraising
GIVE
Pledge to give - We currently have 25 regular givers, totalling a monthly income of £2,150. Can we get 75 regular givers to pledge to give regularly to Impact for the next 1-3 years? Pledge here.
SHARE
A BAPTISM POOL FUNDRAISER is coming!!
Launching in the next few weeks, this will be a great way to share Impact with your friends, family and connections around the globe, to give them and opportunity to be part of the project!
Got a question about Impact? The team would love to you from you on impact@belfrey.org, or come and chat with us at church!
Praise the Lord for all that has been happening in Impact, and for all that is to come!
